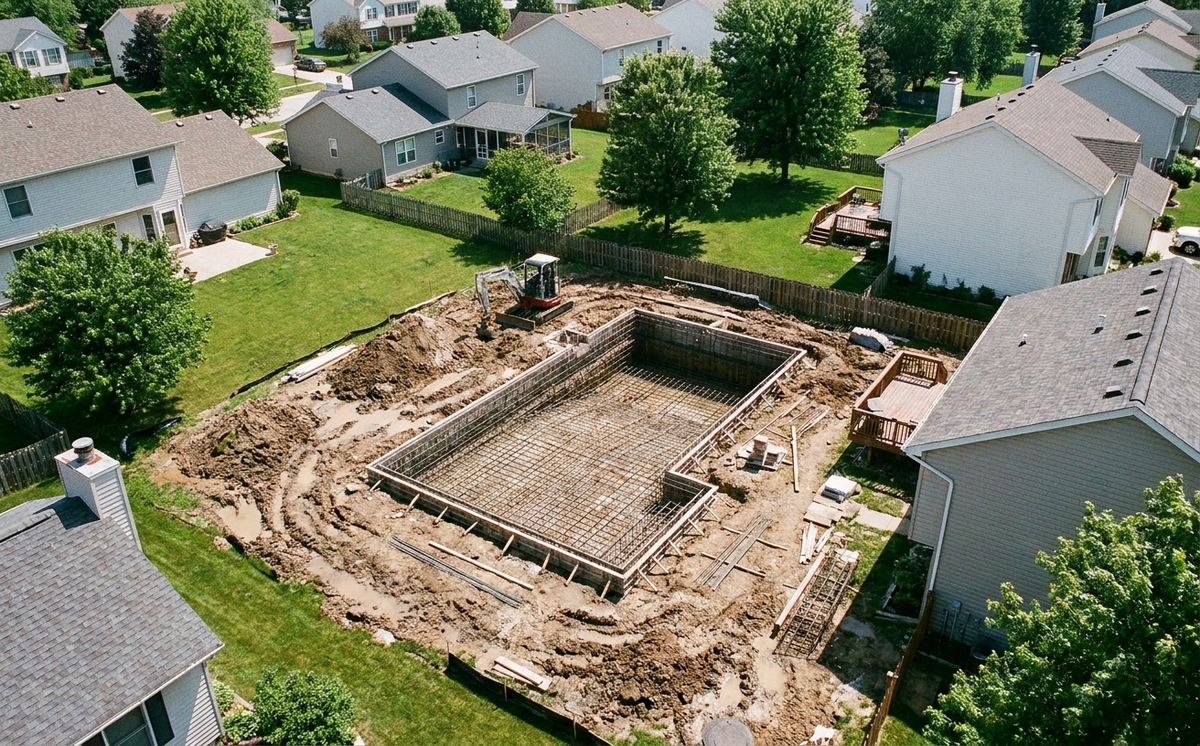

Building a pool takes 6 to 16 weeks from permit filing to first swim. Concrete pools run longest at 10 to 16 weeks. Fiberglass pools are fastest at 3 to 6 weeks. Vinyl liner pools fall between 4 and 8 weeks. Pool type, permit speed, weather, and contractor availability all shift that number, and most of those variables are not in your control.
Pool Build Timeline by Pool Type
The table below covers every major phase of a residential pool build. Permit and design timelines are the same across all three types because they depend on local government, not the pool itself. The shell phase is where the timelines diverge most sharply.
|
Phase |
Concrete |
Fiberglass |
Vinyl Liner |
|
Permits & design |
2–6 weeks |
2–6 weeks |
2–6 weeks |
|
Excavation |
3–5 days |
1–2 days |
2–3 days |
|
Shell / structure |
4–8 weeks |
1 day (shell drop) |
1–2 weeks |
|
Plumbing & electrical |
1–3 days |
1–3 days |
1–3 days |
|
Interior finish / liner |
1–2 weeks |
3–5 days |
1–3 days |
|
Decking & landscaping |
1–3 weeks |
1–3 weeks |
1–3 weeks |
|
Final fill & inspection |
3–7 days |
3–7 days |
3–7 days |
|
Total estimate |
10–16 weeks |
3–6 weeks |
4–8 weeks |
Permits are the most unpredictable line item. Some counties approve in days; others take the full six weeks. That variable alone can push your project start by a month before a shovel touches the ground.
How Long Each Pool Type Takes to Build
How Long Does It Take to Build a Concrete Pool?
A concrete pool takes 10 to 16 weeks from permit approval to first swim. The shell is the bottleneck. After the gunite or shotcrete is sprayed and shaped, it needs 4 to 8 weeks to cure before plumbing and electrical work can begin. Curing slows further in cold weather. The interior plaster or pebble finish at the end adds another one to two weeks. Custom features such as tanning ledges, water features, or a built-in spa push the timeline toward the upper end of the range.
How Long Does It Take to Install a Fiberglass Inground Pool?
A fiberglass inground pool is typically swim-ready in 3 to 6 weeks once permits are approved. The shell arrives pre-manufactured and is craned into the excavated hole in a single day, which cuts out the weeks of curing time that concrete builds require. The remaining schedule covers backfill, plumbing, electrical, and decking. Fiberglass shells are available in fixed sizes and shapes, so layout options are more limited than with concrete.
How Long Does It Take to Install a Vinyl Liner Pool?
A vinyl liner pool typically takes 4 to 8 weeks once excavation begins. The steel or polymer wall panels go up faster than a gunite shell cures, but each panel must be set correctly and the liner measured and fitted carefully. A wrinkle or void in the liner can require the entire fitting to be redone, which is the most common source of delay in this pool type.

How Long Does It Take to Put Up an Above Ground Pool?
A standard round or oval above ground pool kit can be assembled in one to three days. Leveling the ground, setting the frame, installing the liner, and filling with water are all straightforward tasks that do not require permits in most jurisdictions. Removing the permit step is the single biggest time advantage above ground pools have over in-ground options.
Semi-inground or partially buried pools take one to two weeks because partial excavation and reinforced site preparation are required. Some municipalities treat semi-inground installations as in-ground pools for permitting purposes, which can add 2 to 6 weeks. Confirm local requirements before purchasing.
What Can Delay a Pool Build?
Permit resubmissions are the most common delay. A missing document at submission triggers a correction request and resets the review clock. The most frequently missing items are setback measurements, drainage plans, and signed electrical specifications. Contractors who have done many local projects typically know what each jurisdiction requires and submit complete packages the first time.
Weather stops multiple phases. Rain halts excavation. Cold slows concrete curing. High winds disrupt plaster application. A single stretch of bad weather during the shell phase can set a concrete project back by a week or more.
Subcontractor scheduling is less visible but equally common. Plumbers, electricians, and decking crews each run their own calendars. When one phase runs long, the next trade may not be available for another week. Ask your contractor whether subcontractors are in-house or hired independently, and how scheduling conflicts are handled.
Soil conditions affect excavation time and can require additional structural reinforcement. Rocky soil, high water tables, and expansive clay all add both time and cost. A soil assessment before design is finalized can surface these issues before they become mid-build surprises.

How Long Does It Take to Get a Pool Permit?
Pool permit processing takes 2 to 6 weeks in most U.S. jurisdictions. High-volume building departments and those with stricter review requirements run closer to six weeks. Some counties clear permits in under one week.
A complete application typically includes a site plan with pool location, setback distances, and drainage layout, plus structural specifications and electrical plans. Submitting everything correctly the first time is the only reliable way to avoid adding weeks to the wait. Some contractors apply for permits before the homeowner signs the final build contract to get into the queue early.
What Is the Best Time of Year to Build a Pool?
Fall is the best time to start planning and apply for permits if you want a pool ready for summer. Applications submitted in October or November in most U.S. markets can clear before spring, leaving the February to May window for construction and a June completion.
For concrete pools, avoid scheduling the shell pour during sustained freezing temperatures. Most contractors in cold climates delay the gunite phase until daytime temperatures are reliably above 40°F. In warmer states such as Arizona, Florida, and Southern California, construction runs year-round, but contractors in those markets often carry backlogs of three to six months. Starting the search in fall gives more contractor options and better scheduling leverage.

Pool Maintenance After Construction
Water chemistry needs attention from the first fill. In a newly plastered concrete pool, the plaster cures for one to two weeks in the water, and pH fluctuates more sharply during this period. Brushing the walls daily and testing the water every day for the first two weeks is standard practice.
Debris and fine particles settle faster than most new pool owners expect. A robotic pool cleaner running on a set schedule handles floors, walls, and the waterline automatically. The iGarden Pool Cleaner K70 covers all three surfaces on a single charge, runs up to 7 hours, and returns to dock when the battery is low. An app-based AI Timer lets you set it on a 24-, 48-, or 72-hour cycle, which is practical for the daily brushing phase right after a new pool is filled. It fits residential pools up to 20 x 39 ft.
FAQs
Can a pool be built in 30 days?
A fiberglass pool can be completed in 30 days if permits are already in hand and weather cooperates. Concrete pools cannot. The shell phase alone takes 4 to 8 weeks.
Does pool size affect build time?
Yes. Larger pools require more excavation, longer plumbing runs, and more electrical work. The difference between a compact and a large concrete pool is typically one to three weeks across the full build.
How long does it take to fill a pool with water?
A standard residential pool fills in 12 to 36 hours with a garden hose, depending on pool volume and water pressure. Water chemistry stabilization takes an additional 2 to 7 days. For newly plastered concrete pools, the curing period extends active maintenance to about two weeks before swimming is recommended.
Can you build a pool in winter?
Yes, in mild climates. Construction runs year-round in Florida, Texas, Arizona, and Southern California. In regions with sustained freezing temperatures, concrete shell work is typically paused until spring because cold compromises curing. Fiberglass and vinyl liner installs are less sensitive to temperature and can often continue through winter.
